Many organizations use JIRA as a one-shot resolution to automate their processes, and JIRA has virtually develop into synonymous with Agile. Even organizations that don’t deploy it throughout all ranges use it for not less than a number of their tasks. Such is the recognition of JIRA. So, what precisely makes it so well-liked? JIRA gives a easy and easy-to-use resolution for venture administration duties, proper from gathering necessities to sustaining releases and producing all types of reviews and metrics. The finest a part of the device is that it’s extremely customizable, attending to the wants of every one. If it’s mentioned that there isn’t a factor that one can’t do utilizing JIRA when it comes to venture administration, then that isn’t an understatement.
Since Agile is the buzzword now and most organizations are choosing it, this text will present customers with a detailed perception on the right way to perform their venture administration duties and software program growth actions by utilizing a Scrum framework.
Earlier than transferring forward, there are two fundamental pre-requisites that the person who intends to make use of JIRA should have and they’re:
Pre-Requisites:
- An active account on JIRA
- Required permissions (Tremendous Admin, Venture Admin, and so on. – Outlined by organizations)
1. Creation of Venture:
The primary and most important factor is to create a venture in JIRA underneath which we can be finishing up our actions and monitoring the progress of these. There are two methods a person can create a venture.
Methodology 1:
Step 1: Log in to JIRA utilizing your credentials. As soon as you’re logged in, you will land on the venture dashboard which is able to look one thing like this.

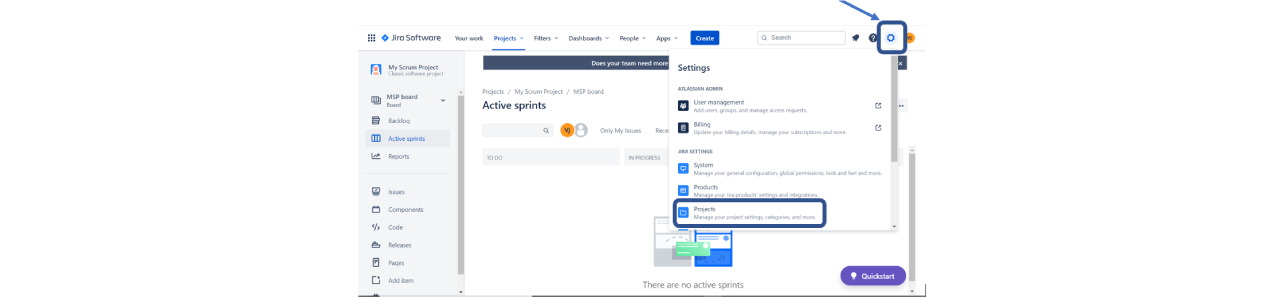

Step 2: Click on Settings icon and choose the Tasks choice as highlighted within the picture under.

Step three: Choose “Create Venture” choice as proven within the picture.

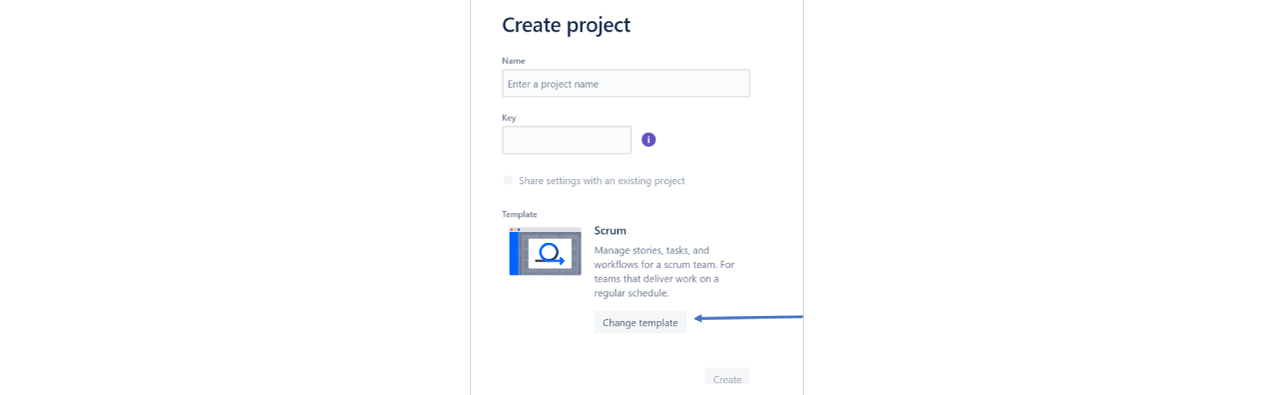

Step four: After clicking on “Create Venture”, you can be prompted with two choices to pick from.

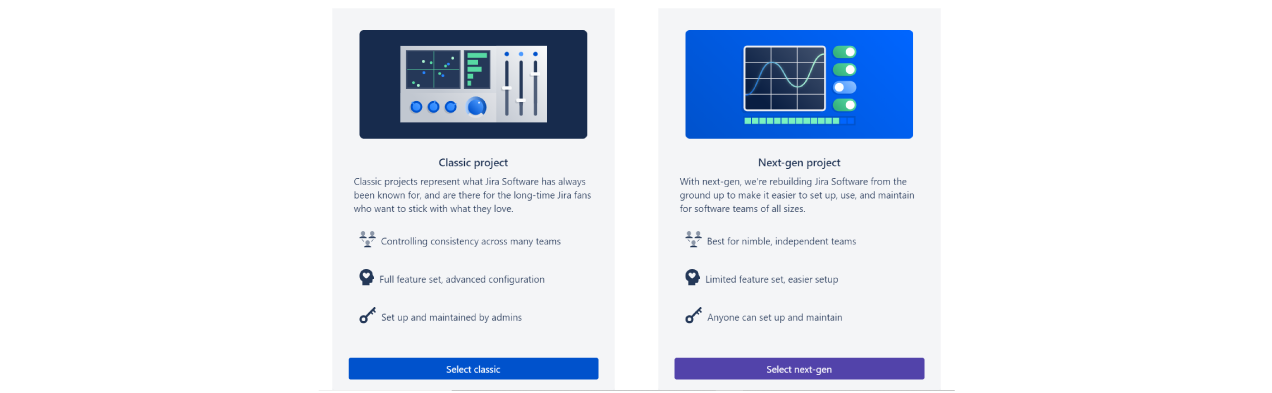

- Basic Venture
- Subsequent Gen Venture

Step 5: As soon as you’ve got chosen the kind of venture, you can be requested to enter the Venture identify. You can even have the choice to alter the kind of template i.e Scrum, Kanban or Bug Fixing, relying on the aim for which you would like to make use of JIRA. As soon as performed, you will need to click on on the “Create” button.

And voila, it’s that straightforward. As soon as you’ve got clicked on the create button, you will land on the venture dashboard with the identify of the venture highlighted on the highest left. As we will see in the picture under, venture identify “My Scrum Venture” is seen.
Methodology 2.
The steps stay the identical, solely distinction is that as an alternative of navigating by way of settings, as soon as you’ve got logged in, you can have the choice to navigate through “Tasks” hyperlink as depicted within the pic.

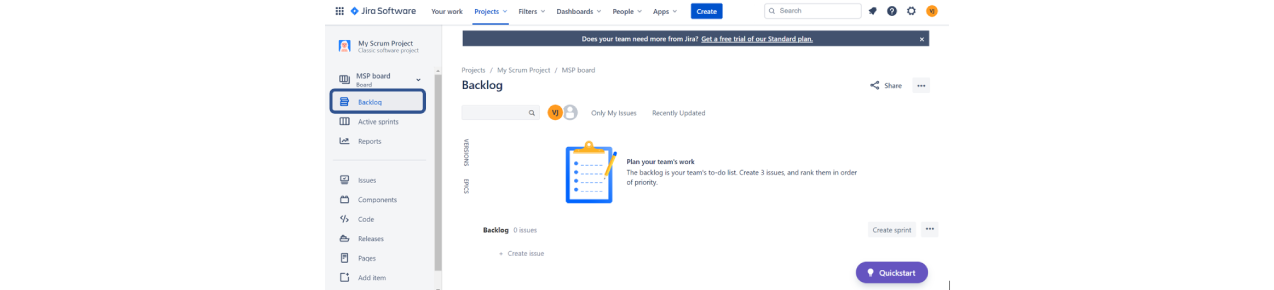

2. Creating Backlog:
As soon as the venture has been created the second vital step is to outline necessities in a backlog. As you’ll be able to see within the pic under, tright here is the choice to pick “Backlog” from the left aspect panel/navigation pane to navigate to the backlog part.

Right here you can begin creating backlog gadgets. This backlog serves because the “Product Backlog”. Users can define necessities when it comes to Epics, Consumer Tales, Duties and Bugs that are often called “subject sorts” in JIRA. In brief, all the things that’s created is a matter in JIRA. Please word that for ease of understanding and reference, I’m sticking to probably the most fundamental subject sorts as talked about above.

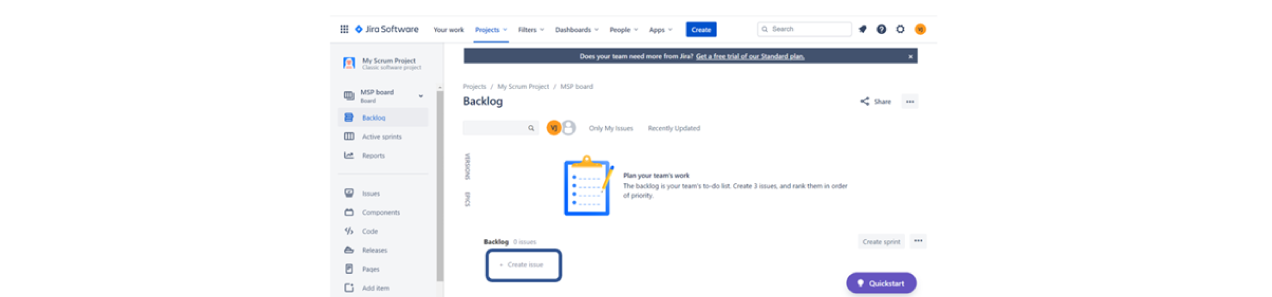

Step 1: To create points in JIRA, all that is required to be performed is to click on on the “Create” button on the highest most navigation bar. This bar stays seen always by default, regardless of whichever web page you navigate to.

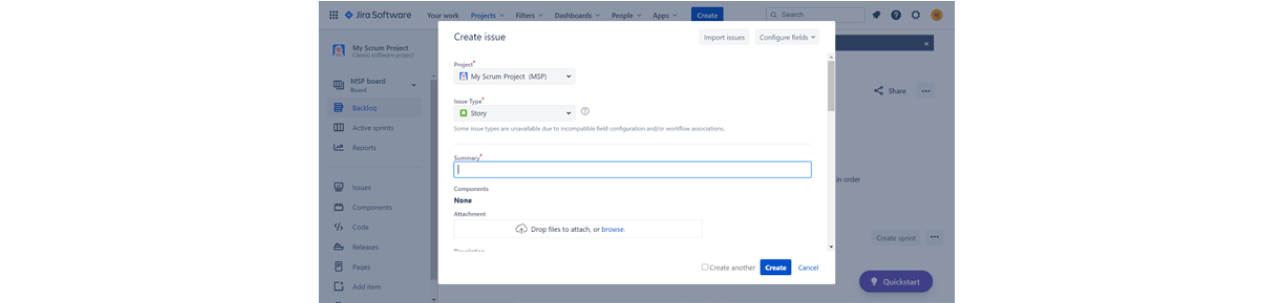

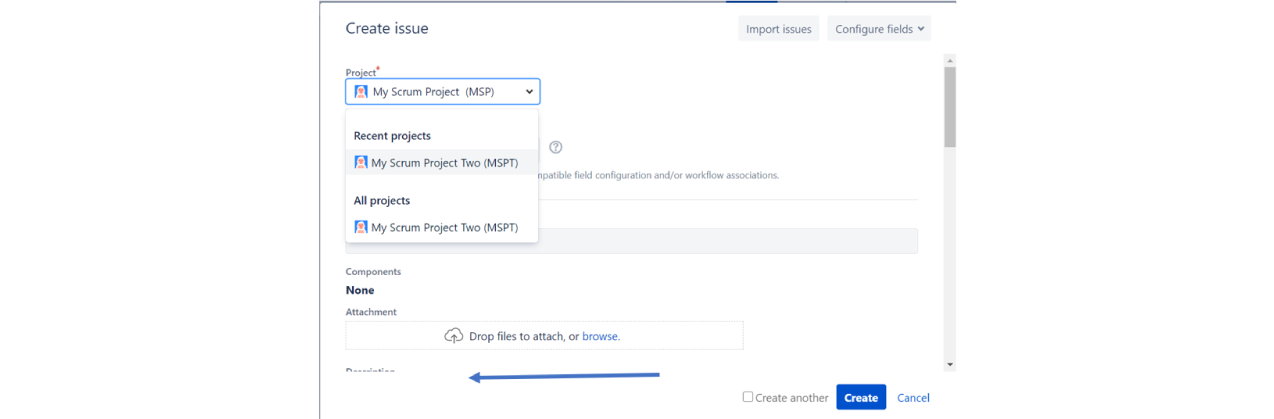

Step 2: As soon as the person clicks on “Create”, a dialog field to enter particulars of the difficulty will open.

The two most vital fields on this are:
-
Venture: This discipline, by default, is populated with the identify of the venture you’re in. But in case you would like to alter the venture discipline, the identical might be chosen from the dropdown

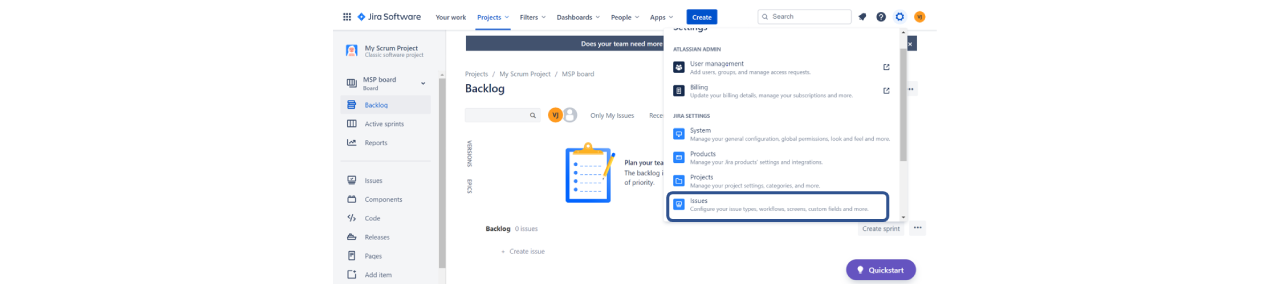

- Challenge Sort: This selection by default is chosen as “Story” however might be modified relying on which subject you need to create. The related subject might be chosen from the dropdown. Beneath picture reveals the way it all seems like in JIRA.
There are two forms of fields on the dialog field; Obligatory and Non-Obligatory. Obligatory fields are marked with a purple Asterix. Additionally, these fields change on change of the difficulty kind i.e. on foundation of what’s relevant to the difficulty kind being chosen.
As already talked about, JIRA is very customizable and a JIRA admin can add or change extra subject sorts based mostly on what terminology is being utilized by the venture and/or group on the entire. E.g. Challenge kind of Options can be added in case groups comply with a feature-based growth strategy whereby options are divided throughout groups and embody the hierarchy of epics and tales.
In an analogous method, subject kind “Story” might be amended to be displayed as “Consumer Story” or at occasions to be extra particular, one thing like “Purposeful Consumer story” and/or “Technical Consumer story”.
Along with this, the fields are additionally customizable. New fields might be added and the rule of necessary and choice discipline can be altered relying on what works finest for the workforce.
To make these changes, the JIRA admin must navigate to the settings part and then to the desired settings kind to alter them. Please word that these settings will solely be obtainable to the person who both is a JIRA admin or has permission to carry out these actions. Permissions are issued by the JIRA admin to the person.

Coming again to the subject of creation of backlog, once you refill the main points and click on on “Create” on the backside of the dialog field, a brand new issue is created in JIRA that now begins reflecting in the backlog.
Points can be created by utilizing the brief lower hyperlink obtainable within the backlog part as highlighted under.

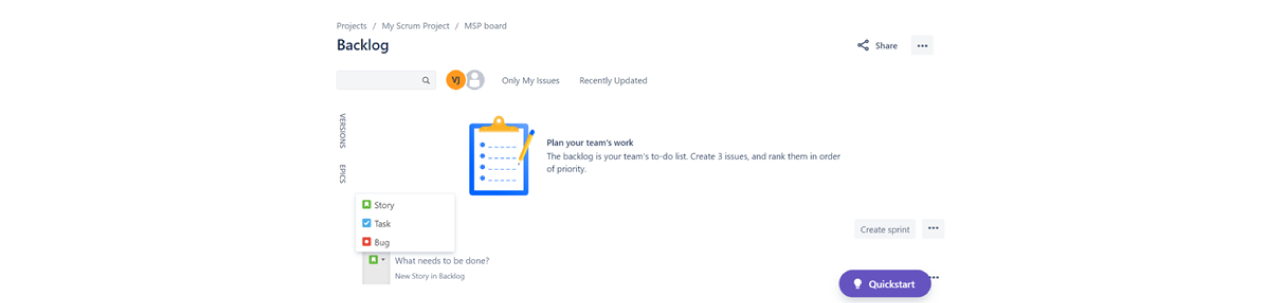

As soon as you click on on “+” icon, you will be capable to choose the kind of subject to create and supply a abstract for a similar.

After coming into the abstract particulars, you’re required to click on enter and the difficulty is created. To enter different particulars, you should navigate to the created subject by clicking on it in backlog or opening the identical in a new tab after which doing the needful.

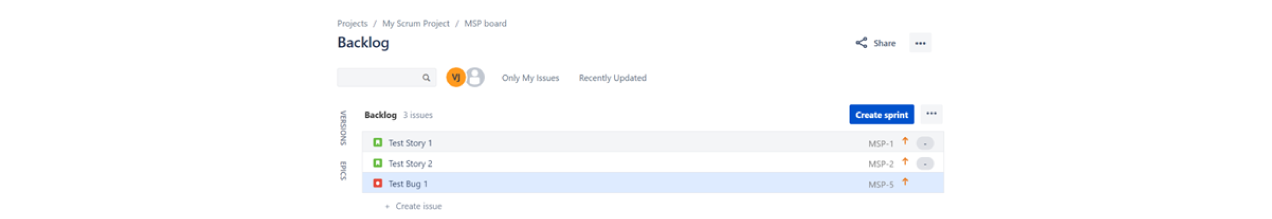

As quickly as an subject is created, the identical begins reflecting in the backlog. Right here you’ll be able to see two tales and one bug that have been created, are seen within the backlog.

1. Linking Points:
Everyone knows the hierarchy of necessities goes one thing like Epics > Tales > Duties. JIRA provides us the aptitude to hyperlink one subject kind with one other. To begin with as a really fundamental ask, tales will fall underneath the epics and thus must be linked with the right epic. This linkage is one thing which replaces the requirement traceability of conventional fashions. When all the things is completely linked then it may be simply recognized which requirement from the shopper was coated underneath which epic and if we go into a granular stage, underneath which story and even duties the necessities fall under. Equally, if a bug is discovered within the story whereas engaged on it, the bug can be logged and linked in opposition to the story.
To hyperlink points, the steps under might be carried out.
Epic Hyperlink: To hyperlink tales underneath an epic, JIRA particularly gives the sphere “Epic Hyperlink” in tales. The discipline at most occasions is made necessary by groups to guarantee that each story that’s created in JIRA is by default linked to the epics. Right here the epic turns into the guardian subject of the story and thus it additionally turns into straightforward to guarantee that each requirement has been labored upon.
Step 1: There are two methods to create the Epic hyperlink. While creation of the story, you can have the choice to say Epic hyperlink or if the story is created utilizing shortcut hyperlink, the identical might be added by opening the story after which mentioning the epic within the epic hyperlink discipline as proven under.

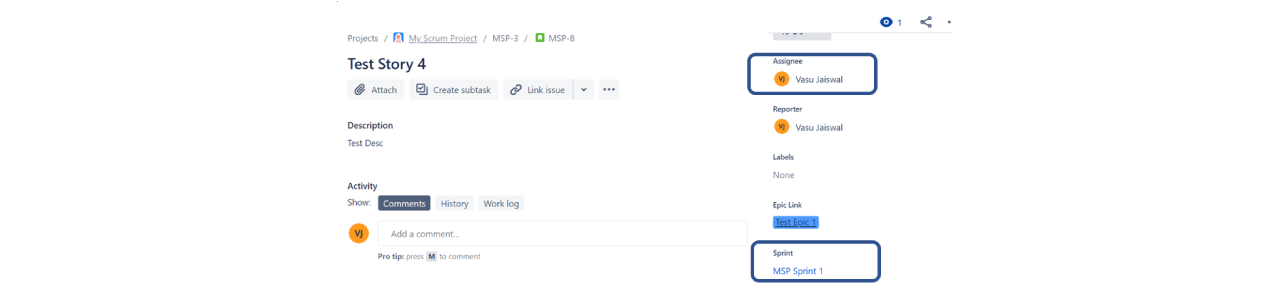

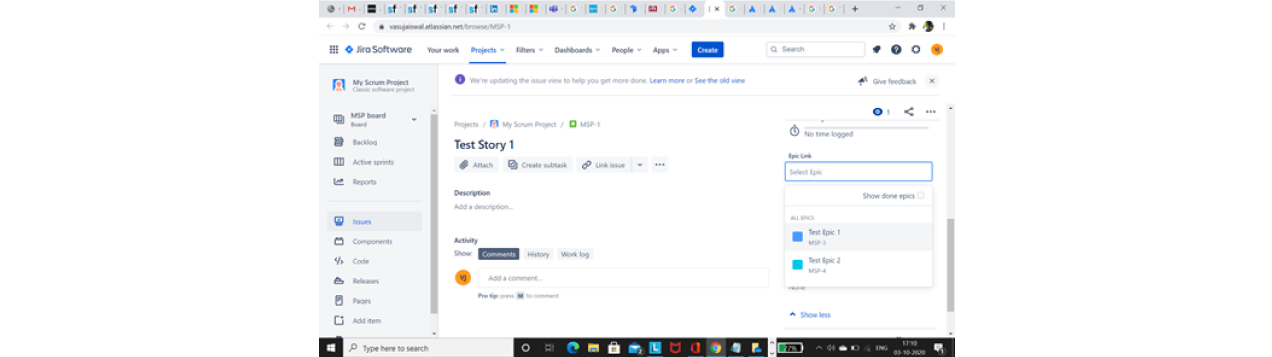

Step 2: As soon as chosen the identical begins reflecting within the story particulars.
Step three: To see the linkage, you want to navigate again to backlog. The hyperlink begins displaying within the backlog.

2. Linking Bugs:
As soon as the bugs are created, they can be utilized to dam person tales in a similar way, although there isn’t a particular discipline like epic hyperlink in case of bugs, they are often linked utilizing the “Hyperlink subject” choice.
Step 1: As soon as the bug is created, word the difficulty ID and open the story which must be blocked and choose the “Hyperlink Challenge” choice.
Step 2: By default, “is blocked by” choice is chosen, indicating that the story is blocked because of the following subject. As quickly as you enter the bug subject id and click on on hyperlink, the story is linked with the bug or to be extra particular, the story is marked ‘blocked’ by the bug. On this means a number of tales might be blocked with a single bug and vice versa.
Be aware – Tales might be linked to different tales to showcase linkage, to mark dependency, to show duplicity/redundancy and so on in the identical method, all that is required is to choose the appropriate choice from the dropdown after deciding on “Hyperlink subject”.
Challenge Prioritization in Backlog.
Because the rule goes, the product backlog have to be prioritized always i.e. the difficulty with the highest precedence must be on the high and the difficulty with least precedence must be on the backside of the backlog, in order that the workforces engaged on the backlog have a clear thought concerning the work they should pull in as soon as the following iteration begins or to grasp if they’ve capability for extra through the ongoing dash. Preserving the backlog prioritized additionally assists the workforce to maintain working as per the product roadmap in the absence of the product proprietor and as such the workforce doesn’t get blocked.
JIRA additionally gives the aptitude to maintain the backlog prioritized always by the straightforward perform of dragging and dropping the difficulty above or under the opposite ones. Beneath photographs provides you with an thought of the identical.

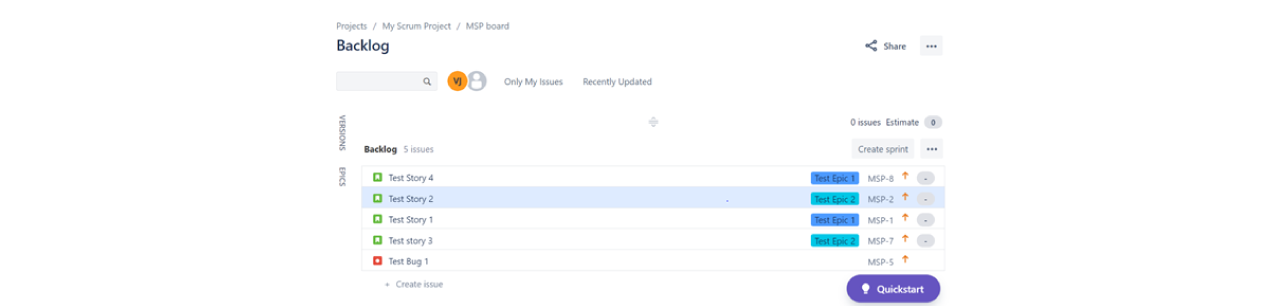

Situation 1: As soon as you begin creating points within the backlog, the points begin reflecting within the ascending order of their Challenge IDs i.e. the order during which they’re created. For ease of reference, the points have been named as 1, 2, three, four and positioned one after the opposite.
Now assume that the precedence of Story four is the best and thus it must be on the high of the backlog, adopted by take a look at story 2, adopted by 1 and three respectively. Thus, they need to be positioned in order of four,2,1 and three within the backlog. This may be performed by merely dragging the gadgets to carry them within the desired order.

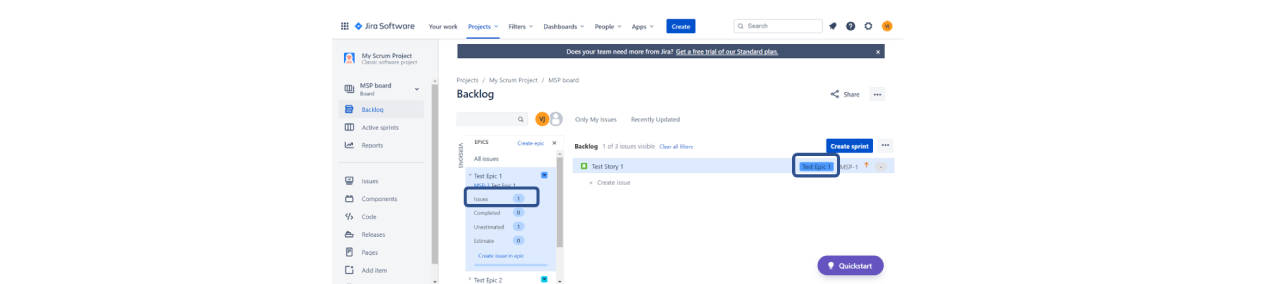

Situation 2: Beneath picture provides you a backlog which is sorted on the premise of prioritization of tales as per the precedence outlined by the PO.

Bugs too might be dragged and positioned at the related place within the backlog relying on their severity and precedence. All these actions of creation and prioritization of backlog are performed primarily by the PO. In case the PO is supporting a number of groups and there are BAs supporting particular person groups or performing as proxy POs for the groups, then POs can leverage them for backlog administration. Scrum grasp wants to make sure that the backlog is prioritized, correctly detailed and not less than the tales for the speedy subsequent dash stay in a prepared state.
three. Creating & Beginning a Dash:
As soon as the backlog has been created, the subsequent step for the workforce is to assemble and maintain the dash planning occasion. PO can open the tales and focus on the main points and Acceptance Criteria with workforce members. As soon as all of the tales have been mentioned, the workforce can begin pulling the tales within the dash and for that to occur the workforce will want a dash in JIRA. It’s once more quite simple.

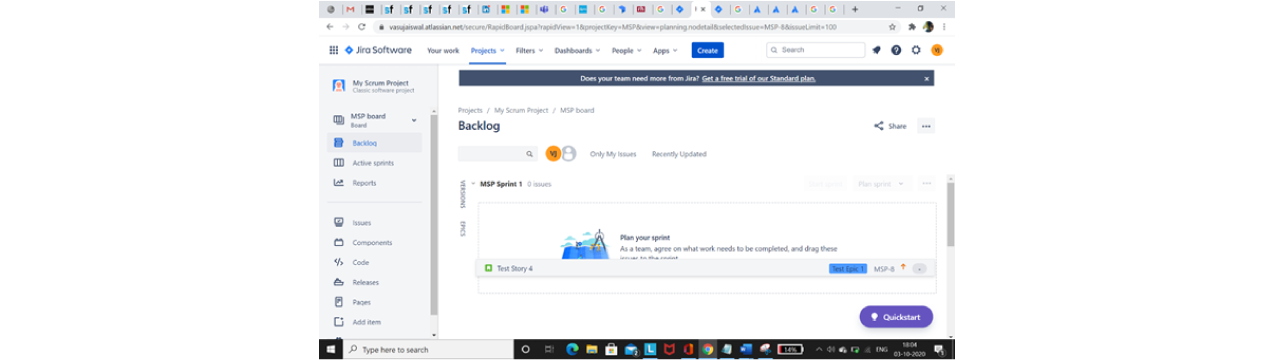

Step 1: Within the backlog part, there’s a “Create Dash” button.

Step 2: As soon as you click on on the button; a dash is created, ranging from dash 1 with a prefix of venture ID as proven in the picture under. You might have the choice to create points immediately within the dash utilizing the fast hyperlink as talked about above for the backlog or the problems might be dragged and dropped within the dash created. All the problems dragged and dropped within the dash created, as mentioned in dash planning, will function the dash backlog.

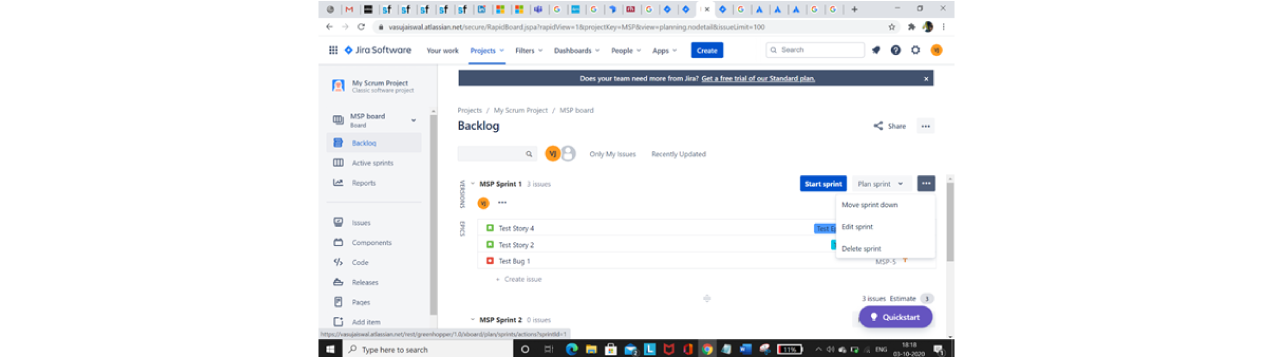

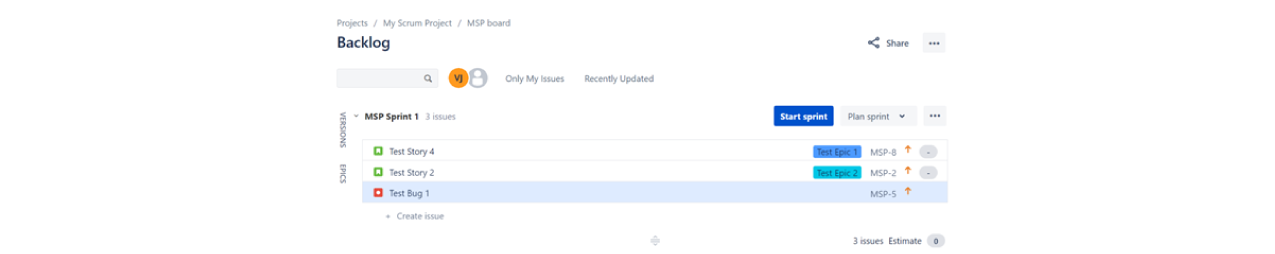

Step three: As soon as all the problems are dragged and dropped within the dash, the dash is able to be began. For example, we see that take a look at story four and a couple of as effectively as a bug have been dragged to dash 1 as displayed in the picture under.

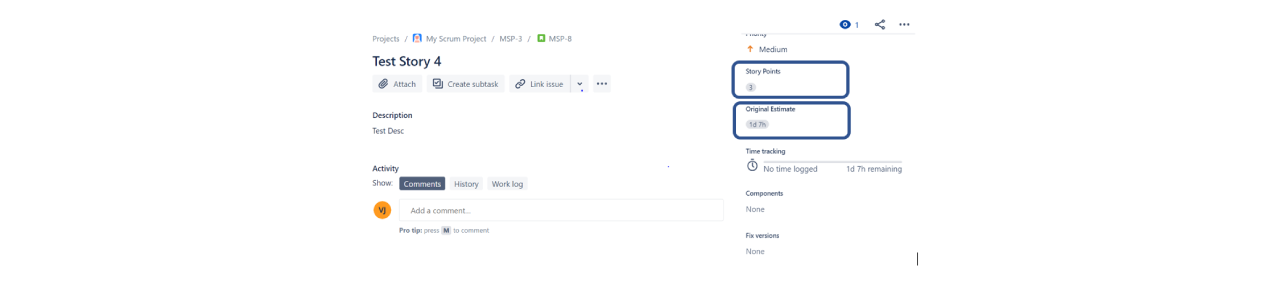

Please word as a part of dash planning session, particulars like Story Assignee, story factors and hourly estimates might be stuffed within the tales utilizing the fields obtainable. Additionally, in case the story proprietor needs to focus on the person duties they intend to carry out as a part of engaged on the story like Evaluation, Coding, Assessment and so on or in case a number of workforce members are engaged on a single story then to focus on particular person work assignments, the choice of making duties can be utilized. Duties might be created identical to tales, as talked about above. It’s just like work breakdown in conventional fashions.

What must be made certain is that earlier than marking the dash planning as being full, all of the tales have been pulled in dash and assigned and estimated when it comes to story factors or hours or each, in keeping with the strategy the groups have determined to take. All of the sub duties that have been created, can optionally be assigned. If desired, these subtasks can be estimated. As soon as all that is performed, the Scrum Master can then mark dash planning as full and proceed to begin the dash.

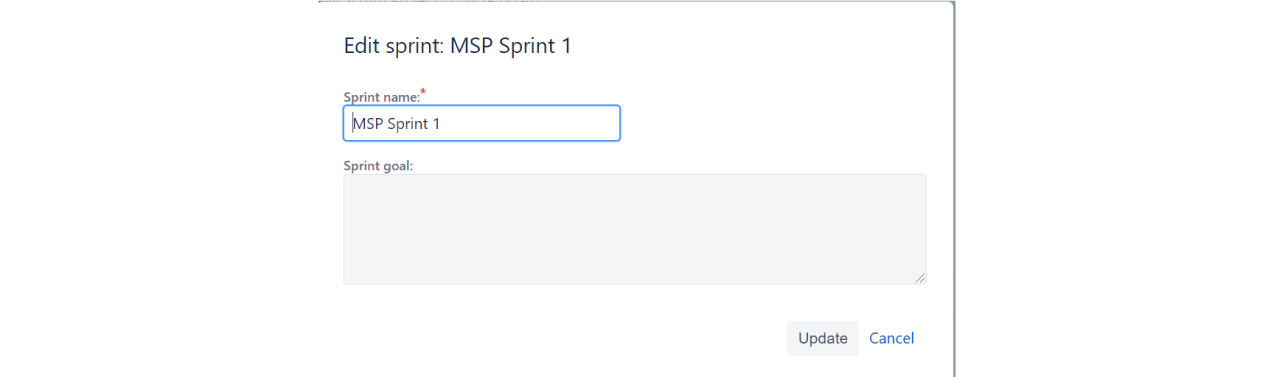

As we all know that earlier than dash planning, a objective is supplied by the PO to the workforce. The identical objective might be added within the dash. Simply choose the three dots choice moreover the dash on proper aspect and choose edit dash and you will be capable to enter the dash objective.

four. Beginning Dash:
As soon as the planning is full and actions like estimations, assignments and tasking have been performed, it is time to begin the dash. This is easy to do. Within the backlog, there’s a “Begin Dash” button. As soon as you click on on it, a dialog field seems the place you can confirm dash objective and set a length for the dash. After reviewing the main points, you can click on on “Begin” and we’re good to go.
5. in Progress:
As soon as the dash has began, you can navigate to the “Lively Dash” part to visualise the progress on the tales within the dash. Group members can replace the tales to depict statuses from “To Do”, “In Progress” and “Carried out” and likewise replace their every day hours within the tales in case groups are estimating when it comes to hours.
6. Finishing/Closing Dash:
On the final day of the dash, it is very important mark the continued dash as closed in JIRA in order that subsequent dash might be deliberate and began.
All of the gadgets that are marked performed are thought-about full. Something pending to be accomplished is both moved to the following dash or to backlog in session with the PO.

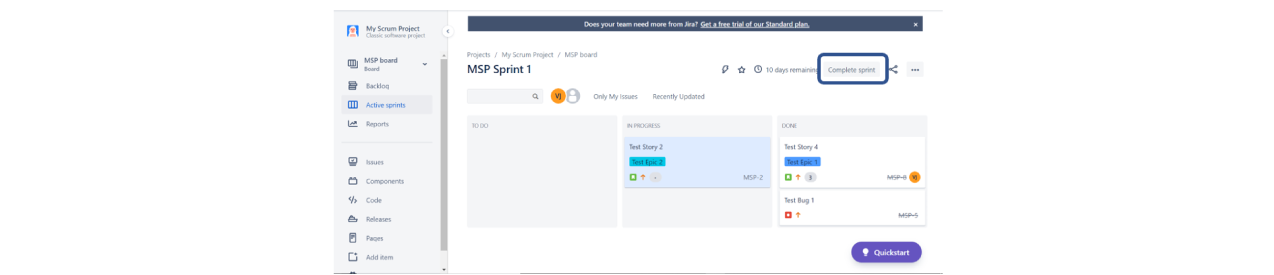

Step 1: Within the “Lively Dash” part. On the highest proper nook, you want to click on on “Full Dash” button.

Step 2: As soon as the “Full Dash” button is clicked, a dialog field seems with particulars of points which were accomplished and those that are pending. Choose the place the place you would like to maneuver the pending gadgets to, both to the backlog or subsequent dash which is to be began.
Step three: As soon as you choose the specified worth underneath “Transfer to” discipline and click on on “Full” button the Dash is marked as full.
